Taking-in-charge documentation: what councils expect

The requirements are rarely the hard part. Keeping the certificates, as-constructed drawings, CCTV, test results and Safety File together for the life of the job is. What every council asks for, where policies differ, and how to build a records pack that holds up at the application.

On this page

The developer’s question is usually some version of this: what does the council need in the taking-in-charge pack, and why does the application keep coming back?

No single national form answers it. The statutory process runs the same way across Ireland, and each council adds its own policy and specification on top. The core documents look familiar from one council to the next: compliance certificates, as-constructed drawings, a CCTV survey and Safety File material. The extras change: drawing conventions, inspections during construction, and how the council wants the evidence delivered.

This guide is for consulting engineers and inspection firms who assemble that evidence or keep it for the developer. It does not replace the council’s current Taking in Charge Policy, the planning permission or project-specific advice.

For SuDS assets that may or may not be adopted with the estate, see SuDS maintenance in Ireland: responsibilities, inspection and handover.

What taking in charge is

Taking in charge is the legal process that hands the public parts of a private housing estate to the bodies that will look after them. The council takes the roads, footpaths, public lighting, surface water drainage and public open space. Uisce Éireann takes the watermains and foul sewers.

Two provisions carry the process:

  • Section 180 of the Planning and Development Act 2000 (as amended), for developments of two or more houses with new roads, open spaces, car parks, sewers, watermains or drains.
  • Section 11 of the Roads Act 1993, the procedure the council follows to declare the roads public.

Department guidance sits in Circular PD 1/08 and Circular PL 5/2014. The last stage is statutory: a public notice, a period for submissions, a report to the elected members and their decision, which is a reserved function.

The developer can apply once the estate is complete, and so can a majority of the owners through a plebiscite. Owners can also ask the council to take an unfinished estate in charge where the council has not taken enforcement action within the period section 180 allows after the permission expired.

Section 180 of the 2000 Act still applies. The replacement sections of the Planning and Development Act 2024 have not been commenced. The note on scope at the end of the article has the detail.

Why the paperwork stalls more applications than the works

When a taking-in-charge application stalls, check the evidence trail before the works. On a lot of jobs nobody treated the records as a live deliverable.

Certificates, inspection records, photographs, test results, as-constructed drawings and CCTV surveys sit with the engineer, the contractor, the developer and, where one is required, the stormwater auditor. Each expects the pack to come together in an afternoon at the end. In practice someone spends days going back through emails, folders and drawing revisions, working out which version is current and whether the evidence exists at all.

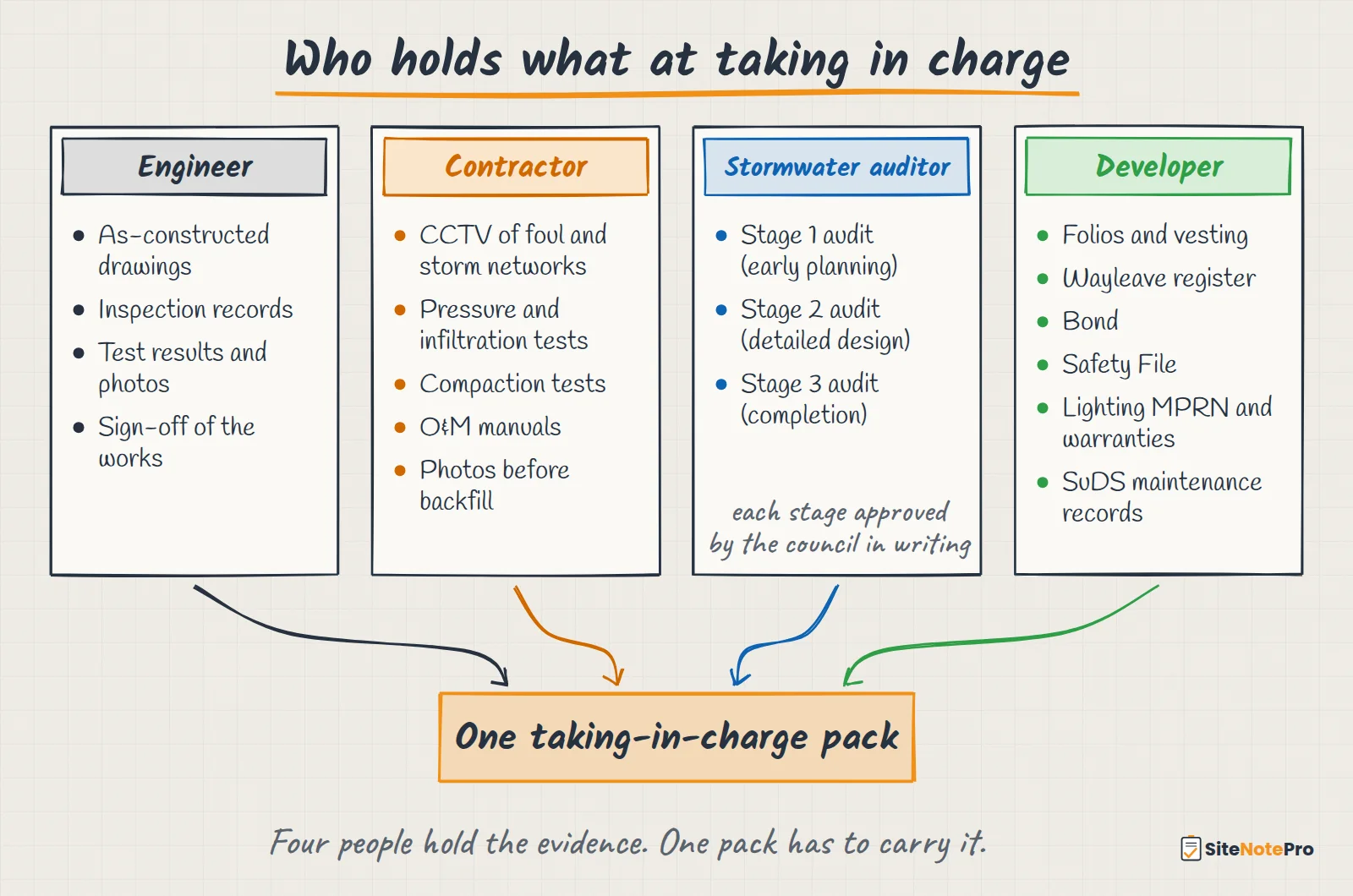

Hand-drawn diagram of who holds the taking-in-charge evidence. Engineer: as-constructed drawings, inspection records, test results and photos, sign-off of the works. Contractor: CCTV of foul and storm networks, pressure and infiltration tests, compaction tests, O&M manuals, photos before backfill. Stormwater auditor: Stage 1, 2 and 3 audits, each approved by the council in writing. Developer: folios and vesting, wayleave register, bond, Safety File, lighting MPRN and warranties, SuDS maintenance records. All four feed one taking-in-charge pack.

Councils that publish their common delay causes list much the same four:

  1. Services such as public lighting or surface water drainage installed in private areas.
  2. Roads, services or open spaces not built to the council’s taking-in-charge policy and specifications.
  3. Private areas, such as parking courts or bin stores, marked as public.
  4. Incomplete Safety File information.

You can catch all four in the records. If the as-constructed drawing still shows a private car park as public open space, or the Safety File is missing test certificates and service photographs, the application stalls even where the works look finished.

BCAR close-out works the same way. By the time you lodge the application, the evidence should already be on file and your job is to check it.

What every council asks for

Across the council policies and taking-in-charge pages reviewed for this guide, the same core set keeps coming up:

  • Certificate of Infrastructure Compliance
  • Certificate of Planning Compliance
  • Certificate of Development Standard
  • As-constructed drawings, with a colour convention that separates public from private areas
  • A CCTV drainage survey, with pipe and manhole references that match the as-constructed drawings
  • Whatever the council’s own policy adds, often bond evidence, open space and lighting specifications, and Safety File material

Certificate titles vary, so read each one as “or your council’s equivalent”. No statutory form sets this list. Treat it as a working baseline and check the council’s current checklist and request form on every job.

Where councils differ

Councils add their own layers on top of the baseline:

  • Drawing conventions. Colour coding for the estate boundary, open space, roads, footpaths, lighting and wayleaves, and which maps must be certified land transfer maps rather than planning or tender drawings.
  • Inspections during construction. Some councils ask for stage sign-offs at set points in the build. Record and sign off each stage as you go either way: you cannot certify a formation level after the road is built.
  • Evidence delivered as you build. At least one council opens a shared folder when the commencement notice goes in on BCMS, so the developer can upload Safety File material, as-built drawings, test certificates and service photographs during construction.
  • Bonds and security. Rates, wording, and whether release waits for wayleave registration, land transfer or open enforcement.
  • SuDS and blue-green infrastructure. Which features the council will adopt, and the maintenance it expects until it does.
  • Adoption scope. Some councils will not take on grass cutting, shrubberies or playgrounds on adopted open space, so agree who maintains each asset before you apply.
  • Programme targets. Some councils commit to dates for acknowledgement, inspection and final inspection, and give you a deadline for the fixes in between.
  • The Safety File. Some policies make it a required part of the request, rather than a PSDP document held elsewhere.

Stormwater audits

A stormwater audit can come from a planning condition or from the council’s development plan, which may require one above a site-size threshold. Where one applies, it becomes part of the taking-in-charge evidence. It runs in three stages:

  • Stage 1 at the early planning stage.
  • Stage 2 at detailed design, agreed in writing with the planning authority before construction starts.
  • Stage 3 at completion, showing the SuDS are installed and working as designed, with no misconnections or damage to the storm drainage.

At taking in charge, the Stage 3 report on its own is not the sign-off. File the planning authority’s written agreement with it, along with the Stage 1 and Stage 2 reports, the design team’s responses to each and the SuDS maintenance records. A Stage 2 audit that was never agreed before commencement becomes a compliance gap at the application, so check the conditions and the development plan on day one.

Watermains and foul sewers

Uisce Éireann takes the watermains and foul sewers in charge and has its own requirements, starting with the connection agreement. Keep its records as a separate trail in the pack: approvals, as-constructed layouts, CCTV, test and commissioning records. Check that the watermain and foul layouts match the drawings the council sees, and keep surface water out of the foul network.

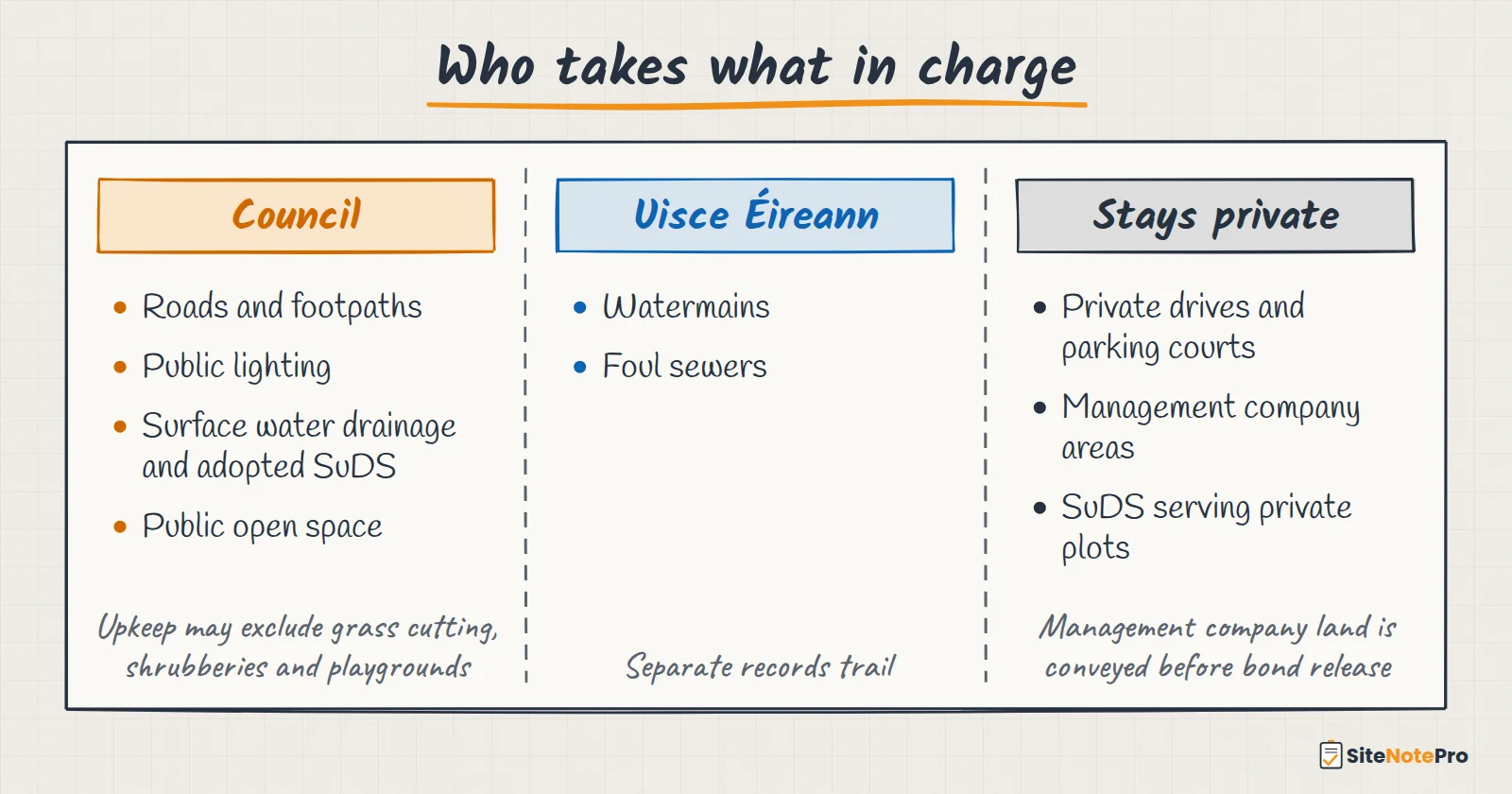

Hand-drawn table of who takes what in charge. Council: roads and footpaths, public lighting, surface water drainage and adopted SuDS, public open space; upkeep may exclude grass cutting, shrubberies and playgrounds. Uisce Éireann: watermains and foul sewers, with a separate records trail. Stays private: private drives and parking courts, management company areas, SuDS serving private plots; management company land is conveyed before bond release.

What goes in a records pack

Most of these items can only be created at one point in the build. Miss that point and the evidence is gone, so open the pack at commencement.

Use the list below as a working index and adapt it to your council’s checklist.

Application and identity

  • Developer or owners’ request form (the council’s form, where it has one), with a majority of homeowners’ signatures where the owners apply
  • Site location map and development particulars
  • Planning permission reference, conditions schedule, and evidence of compliance with each condition that bears on taking in charge
  • Bond status and any open enforcement or compliance matters (many councils will not progress an application while enforcement is open)

Certificates and sign-off (titles vary by council)

  • Certificate of Infrastructure Compliance
  • Certificate of Planning Compliance
  • Certificate of Development Standard, or the council’s equivalent completion certificate
  • As-constructed records signed off by a named competent person, with any stage sign-offs the council asks for
  • Stormwater audit reports with the planning authority’s written agreement, where one is required

As-constructed drawings

  • Taking-in-charge drawing that separates public from private areas
  • Certified land transfer maps drawn on the as-constructed survey, to Tailte Éireann requirements, where the council needs them
  • Foul and surface water drainage, including SuDS, levels and control details
  • Watermain layout
  • Road layout, markings and signage
  • Public lighting and utility ducting
  • Wayleave drawings for services crossing retained private land, with the agreements registered where required
  • Open space and landscaping as constructed

Surveys, tests and manuals

  • CCTV sewer condition survey with pipe and manhole references matching the drainage drawings, and defects fixed and re-surveyed
  • Manhole and pipework condition survey where the council or Uisce Éireann requires one
  • Pressure, air and infiltration test records for watermains and sewers
  • Material and compaction test results, lighting commissioning and other component tests
  • Public lighting MPRN records and lantern and photocell warranties that transfer to the council
  • Operation and maintenance manuals for pumping stations and other mechanical assets proposed for adoption
  • Photo record keyed to asset references and dates

Safety File

  • Safety File prepared under the Construction Regulations (S.I. No. 291 of 2013): as-builts, residual risks and maintenance information, submitted with the request where the council requires it
  • Keys, access arrangements and specialist access notes for adopted assets

Defects and close-out

  • Defect register: the defect, when you found it, what was done and when someone verified it closed
  • Outstanding items list with owners and target dates
  • Correspondence log with the council
  • Maintenance responsibility schedule for every asset: council, Uisce Éireann, management company or private

If SuDS features are proposed for adoption, cross-check the asset register and maintenance records against the SuDS maintenance guide. Do not assume the council will adopt every SuDS feature on the site.

Common reasons applications stall

Cause What usually went wrong in the record
Services in private areas The as-constructed plan does not match what the council can adopt, and there is no wayleave or redesign trail
Roads, services or open spaces not to specification Works not built or not proven to the council’s specification; tests or layer certificates missing
Private areas marked public The taking-in-charge drawing includes private parking, bin stores or management company land
Incomplete Safety File As-builts, test certificates, service photographs or O&M information missing
CCTV or drainage survey rejected Pipe references do not match the drawings; defects not fixed and re-surveyed
Stormwater audit not agreed Stage 3 report on file without the planning authority’s written agreement, or no Stage 2 agreed before commencement
Bond or enforcement still open Application lodged before the financial and compliance blockers cleared
Uisce Éireann trail missing Connection agreement records left out, or watermain and foul records that disagree with the council pack
Pack assembled at the end Versions conflict and the inspector cannot follow a continuous record from construction

Readiness check: ten questions

Before you lodge the application or promise a date, you should be able to answer yes to each of these, or have a dated plan for the gaps:

  1. Policy. Have you got the council’s current policy, specification and checklist, not last year’s PDF from another job, and confirmed whether a fee applies?
  2. Planning. Is planning compliance signed off for every condition that bears on taking in charge?
  3. Index. Is there one asset and drawing index that separates council, private, management company and Uisce Éireann assets?
  4. Drawings. Are the as-constructed drawings based on the as-built survey, at the council’s scales and colour conventions, with certified land transfer maps where needed?
  5. Sign-off. Are the as-constructed records complete and signed off by a named competent person, under your council’s certificate titles?
  6. Drainage and defects. Is the CCTV survey complete and referenced to the drawings, with a live defect register showing what was fixed and re-surveyed?
  7. Stormwater and SuDS. Where the permission or development plan requires a stormwater audit, has the planning authority agreed Stage 3 in writing? Have SuDS adoption boundaries and maintenance records been checked?
  8. Safety File. Is it complete enough to submit with the request?
  9. Land and money. Are the bond, wayleave, folio and enforcement positions known and, where required, clear?
  10. Retrieval. Could someone who was not on the job for two years find every item from the index without rebuilding it from email?

The records pack turns this list into a tick-box check with Ready, Gap and Blocker columns.

Download the taking-in-charge records pack

Free tool

Taking-in-charge records pack

The records pack is a print-and-tick index built from this guide: the core items, the common council extras with one council’s layer worked through as an example, who holds each one, document references, open gaps and the ten-question readiness check. Adapt it to your council’s checklist before you submit. PDF, plus an editable Excel version.

A note on scope

This article is general technical commentary on taking-in-charge documentation for Irish residential developments. It is not legal, planning or project-specific professional advice. It does not replace the Planning and Development Acts, the Roads Act 1993, Department circulars, the council’s current Taking in Charge Policy and specifications, Uisce Éireann requirements, the Construction Regulations or advice on the individual appointment.

What a project needs depends on the planning permission and its conditions, the bond and maintenance arrangements, which assets are proposed for taking in charge, and the council and Uisce Éireann documents current at the time. Each project participant remains responsible for matters within their own appointment, competence, work and certification.

As at 3 October 2026, the taking-in-charge sections of the Planning and Development Act 2024 (Part 8, Chapter 2, sections 260 to 265) have not been commenced. The latest commencement order for the 2024 Act is S.I. No. 466 of 2026, which commenced other provisions on 9 September 2026. The Department’s commencement schedule on gov.ie, last updated on 13 May 2026, does not yet list that order, so the Irish Statute Book’s legislation directory is the more up-to-date source. Section 180 of the Planning and Development Act 2000 is still the provision that applies. When it is repealed, section 263 of the 2024 Act will keep it in force for requests made before the repeal. Check the commencement position again on the day you use this guide.

Technical sources and further reading

This article was prepared with reference to the following:

  • Planning and Development Act 2000, section 180, as amended
  • Roads Act 1993, section 11
  • Circular PD 1/08, Taking in Charge of Residential Developments (February 2008)
  • Circular PL 5/2014, Matters related to the Taking in Charge of Residential Developments (November 2014)
  • Planning and Development Act 2024, sections 260 to 265 (not commenced as at 3 October 2026), and S.I. No. 466 of 2026
  • S.I. No. 291 of 2013, Safety, Health and Welfare at Work (Construction) Regulations 2013
  • Related SiteNotePro guide: SuDS maintenance in Ireland

Council policies checked in September and October 2026: Kildare (policy adopted May 2023), Fingal (updated May 2022), Dublin City, Galway County (under review when checked) and Limerick City and County (Taking in Charge Protocol, November 2024, the most detailed of those reviewed, with its Surface Water/SuDS and Public Lighting specifications), plus the taking-in-charge pages of Wexford, Louth, Kilkenny, Cavan, Dún Laoghaire-Rathdown and Longford. Policies change, so check the live council page before relying on any detail.

These sources do not replace the planning permission, the relevant local authority standards, taking-in-charge checklists, manufacturer instructions, health and safety requirements, Uisce Éireann documentation or the terms of any site-specific bond or maintenance agreement. Requirements should be confirmed for the individual development and against the legislation and guidance current at the relevant time.

Sources reviewed September and October 2026.
